Mumbai-Pune Expressway Missing Link Nears Completion, Set for May 1 Inauguration
The Maharashtra State Road Development Corporation (MSRDC) has announced that the long-awaited "missing link" project on the Mumbai–Pune Expressway is now 98% complete, with plans to inaugurate the stretch on May 1, coinciding with Maharashtra Day. This development marks a significant milestone in addressing chronic traffic bottlenecks and enhancing road safety.
Deadlines and Safety Assurances
Senior MSRDC officials confirmed on Tuesday that the April 30 deadline for civil works remains firm, with no further extensions anticipated. In a written reply to the legislative assembly last Thursday, Chief Minister Eknath Shinde emphasized that the revised deadline will be met, despite earlier delays due to geographical and technical challenges. He stressed that traffic will only be permitted once all mandated safety standards and load tests are fully satisfied, ensuring commuter security.
As of March 3, only about 2% of the work remains pending. The Pune-bound corridor is already operational, with just six metres of construction left on the Mumbai-bound side. Trial runs and final safety clearances are scheduled for late April, paving the way for a smooth launch.
Project Urgency Highlighted by Recent Incident
The urgency of this project was underscored by a major accident in early February, when a tanker carrying highly inflammable propylene gas overturned near Khopoli. This incident led to a 32-hour traffic suspension, causing 20-kilometre-long queues and leaving thousands of commuters stranded without access to food or water. The event sparked renewed calls to expedite the missing link, which is designed to provide a safer, alternative route and prevent such disruptions in the future.
Key Features and Benefits
Valued at Rs 6,695 crore, the project connects Khopoli to Kusgaon and bypasses the steep, winding Khandala-Lonavala ghat section—a notorious bottleneck. By shortening the existing 19.8-kilometre stretch by over 6 kilometres, the link is expected to reduce travel time between Mumbai and Pune by 25 to 30 minutes, offering a more efficient commute.
The engineering marvel includes:
- A 900-metre viaduct at Khopoli, standing about 60 metres above ground.
- A 1.64-kilometre tunnel leading into Tiger Valley.

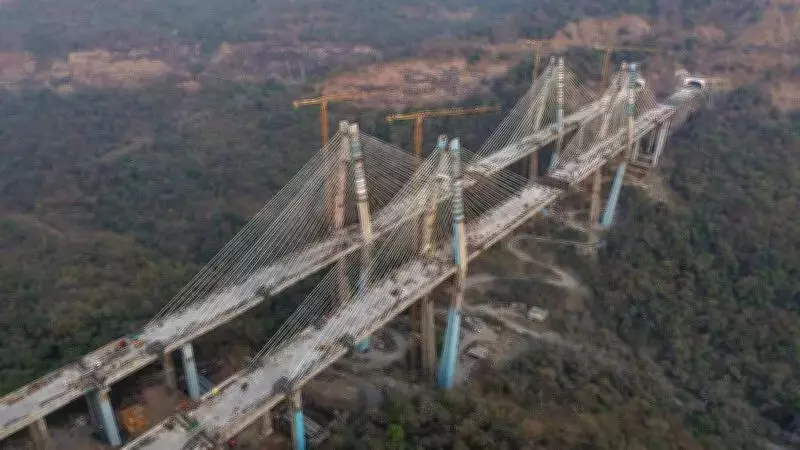

- A 650-metre cable-stayed bridge supported by two 180-metre pylons, considered India's tallest road cable-stayed bridge, executed by Afcons Infrastructure Ltd.
- A nearly 9-kilometre tunnel emerging at Kusgaon on the Pune side.
This new four-lane corridor provides an additional lane of capacity compared to the existing ghat section, enhancing overall traffic flow.
Expected Traffic Impact and Future Use
Highway police anticipate a significant shift in traffic patterns once the link becomes operational. Light motor vehicles, which constitute a large share of expressway traffic, are expected to migrate to the new alignment. Commuters traveling from Pune to Mumbai are likely to benefit the most, as they will no longer be stuck behind heavy trucks struggling on uphill ghat stretches.
Beyond daily commuting, the missing link will serve as a vital diversion during emergencies, offering a high-speed alternative to the old Mumbai–Pune highway. This feature is crucial for maintaining connectivity and safety in unforeseen circumstances.
The completion of this project represents a major step forward in Maharashtra's infrastructure development, promising improved travel efficiency and enhanced road safety for millions of commuters.
