Chennai's Anna Salai Flyover Takes Shape: 1.5-Km Stretch Completed
Anna Salai Flyover: 1.5-Km Stretch Completed in Chennai

Chennai's Anna Salai Flyover Construction Advances with Key Stretch Completion

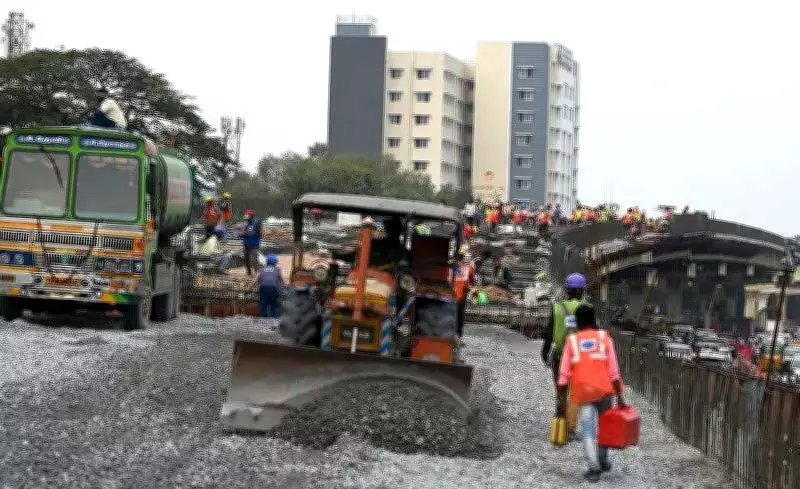

The long-awaited Anna Salai flyover in Chennai has reached a significant milestone, with a crucial 1.5-kilometer section now fully constructed. The State Highways Department has successfully completed the stretch running from Saidapet to CIT Nagar, marking a major step forward in this ambitious infrastructure project.

Project Overview and Progress Details

With a total budget of 621 crore rupees, the flyover will eventually span 3.2 kilometers along one of Chennai's most congested arterial roads. Officials report that more than 50 of the planned 91 piers have already been placed, while pre-fabricated spans transported from manufacturing facilities in Mumbai and Gujarat have been installed along the completed section.

The construction team built an 80-meter bituminous macadam approach road from Saidapet before laying a concrete road extending to CIT Nagar. "We've increased our workforce from 300 to 600 by hiring additional workers from West Bengal to accelerate progress," explained a State Highways Department official.

Wide Pickt banner — collaborative shopping lists app for Telegram, phone mockup with grocery list

Engineering Challenges and Metro Integration

The project presents unique engineering challenges, particularly where the flyover intersects with existing metro infrastructure. Approximately 69 of the 91 pillars will be positioned directly above the metro corridor, requiring careful coordination between agencies. Metrorail has already provided foundational support designed to withstand up to 1,000 tonnes of weight.

Span lengths vary throughout the structure, with the shortest measuring 11 meters and the longest extending to 30 meters. On the parallel stretch from Nandanam to Teynampet, construction has progressed more slowly, with officials noting that pillar placement has only recently begun and visible progress may take another four months to materialize.

Infrastructure Coordination and Traffic Management

Significant preparatory work has been necessary before construction could advance. The recent completion of replacing a 230kV underground electric line has removed a major obstacle to further development. Traffic management improvements are already visible along the completed section, with barricades removed between Saidapet and CIT Nagar and U-turn facilities established at two locations near the Jones Road junction.

Community Impact and Resident Perspectives

Local residents have expressed both hope and frustration regarding the project's progress. G Kamesh, a Saidapet resident, highlighted the ongoing traffic challenges: "Congestion peaks at T Nagar during evening hours. The current diversions through Cenotaph Road in Teynampet and Theagaraya Salai in T Nagar are creating bottlenecks since these routes aren't designed for buses and heavy vehicles."

Kamesh added that while progress is visible in some areas, "barely any development has occurred beyond Nandanam," underscoring the uneven pace of construction across different sections of the project.

The Anna Salai flyover represents a critical infrastructure investment for Chennai, designed to alleviate chronic traffic congestion that has plagued this major transportation corridor for years. As construction continues, residents and commuters await the project's completion with anticipation, hoping for smoother travel along one of the city's busiest thoroughfares.
