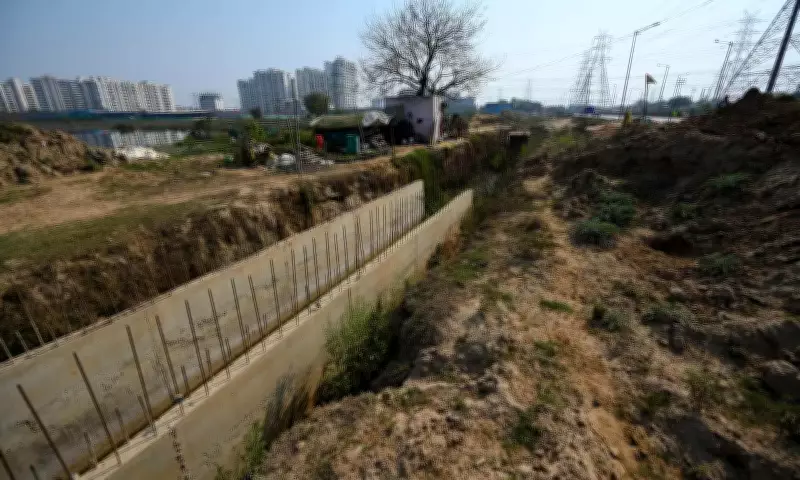

Gurgaon's Drainage Project Delays Spell More Waterlogging for Residents
Residents of Gurgaon sectors 68 to 75 are bracing for another monsoon season plagued by chronic waterlogging, as the Gurugram Metropolitan Development Authority (GMDA) is set to miss its August deadline for a critical drainage project in the area. The slow pace of work has prompted the GMDA to impose a substantial penalty of Rs 5 crore on the contractor responsible for the delays.
Project Overview and Current Status
Conceived in 2022, this ambitious project was designed to address critical gaps in the drainage infrastructure across the newly developed sectors along the Southern Peripheral Road (SPR). It involves laying an extensive 17.6-kilometer stormwater drainage network across sectors 68 to 75, with a total cost of Rs 51 crore. Despite receiving financial approval in July 2024 and targeting completion by August of this year, only approximately 20% of the work has been completed so far.
A GMDA official stated, "We have imposed a penalty of Rs 5 crore on the agency for slow execution and directed it to expedite the work." The project includes the construction of reinforced cement concrete (RCC) box-type drains of varying sizes. These drains are intended to channel rainwater from sectors 68 to 75A into a master drain being developed along the SPR, stretching from Vatika Chowk to NH-48. Ultimately, this system will flow into the Badshapur (Leg-III) drain.
Resident Concerns and Historical Issues
Residents and commuters in the area have long endured significant waterlogging, particularly at notorious spots like Darbaripur Road and Tulip Chowk, which become inundated during heavy rainfall. With key projects falling behind schedule, locals are preparing for yet another monsoon marked by flooded roads and disrupted daily commutes.
Ajay Sharma, a resident of Tulip Ivory, expressed frustration, saying, "The drainage work has been going on at a snail's pace. With the monsoon approaching, we are certain waterlogging will worsen in this area, leading to severe traffic congestion and chaos just like every year."
Partial Relief from Master Drain Project
While the internal drainage network lags, the metropolitan authority is hoping for some relief from the ongoing construction of a master drain along the SPR, known as the Leg-IV drain. This 5-kilometer stretch between Vatika Chowk and NH-48, passing through sectors 69, 70, 75, and 75A, is targeted for completion by June.
The GMDA official added, "Most of the work is completed and only two drainage crossings are left, including at Genpact and Tulip junction. Work on the Sector 75-75A crossing is ongoing, and we are aiming to complete it before the monsoon." The Rs 105-crore Leg-IV project, which will benefit sectors 68 to 80, is expected to reduce the load on the existing Badshapur (Leg-III) drain. This key outfall often overflows during the monsoon, flooding low-lying stretches of the SPR.
Historical Delays and Broader Context
This master drain project has also faced significant delays. Although it received administrative approval in 2019, it remained stuck in planning and coordination stages for nearly three years. Physical work only began in April 2023, and it has already missed its original October 2024 deadline. Officials have attributed early delays to various factors, including monsoon disruptions, construction bans during winter months due to air pollution, and delayed permissions for hillock removal and high-tension power tower adjustments.
Currently, Gurgaon's stormwater is managed through three major master drains: Sikanderpur (Leg-I), Sector 42 (Leg-II), and Badshapur (Leg-III), all of which lead to the Najafgarh drain. The ongoing delays in these new projects highlight the persistent challenges in upgrading the city's drainage infrastructure to cope with monsoon demands.
