Mumbai's Rs 12,000 Crore Pothole-Free Plan Expands Amid Political Scrutiny
Mumbai Road Concretisation Plan Expands to Rs 2,500 Crore Phase

Mumbai's Ambitious Road Concretisation Project Faces Expansion and Political Heat

The Brihanmumbai Municipal Corporation (BMC) is forging ahead with its massive Rs 12,000 crore initiative to eliminate potholes across Mumbai by converting asphalt and paver block roads into durable concrete surfaces. This ambitious plan, originally launched under the direction of former chief minister and current deputy CM Eknath Shinde, aims to overhaul the city's entire 2,050-kilometer road network. As the project progresses, civic sources have revealed that a new phase, estimated at an additional Rs 2,500 crore, is already in the planning stages, sparking significant political debate over its timing and execution.

Project Phases and Current Status

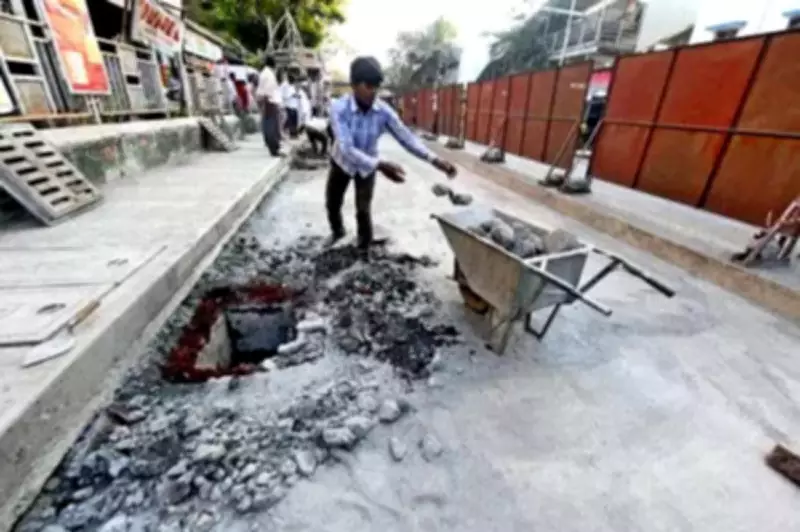

So far, the concretisation drive has been rolled out in two distinct phases. Phase I, initiated in January 2023, targeted 698 roads covering 324 kilometers. Phase II proposes to address 1,420 roads spanning 377 kilometers. Civic officials assert that all ongoing works are on track for completion before the next monsoon season, with over 1,333 kilometers of roads already concretised. This includes major arteries such as Aarey Road, Andheri-Kurla Link Road, Narayan Dabholkar Marg, and key stretches connecting Navy Nagar to Shahid Bhagat Singh Marg.

Political Pushback and Coordination Challenges

Despite official assurances, the project has encountered sharp political pushback. Opposition leaders argue that expanding the initiative with a new Rs 2,500 crore phase is premature, given that parts of the current works remain incomplete. Samajwadi Party MLA Rais Shaikh has highlighted repeated instances of poor coordination, where freshly concretised roads are dug up shortly after completion for other civic works. He cited a recent example on St Andrew's Road in Bandra West, where a section was reopened for upgrades to the Chimbai pumping station, involving micro-tunnelling and chamber construction, much to the dismay of local residents.

Wide Pickt banner — collaborative shopping lists app for Telegram, phone mockup with grocery list

"Inter-departmental clearances are not being properly coordinated. Roads are being concretised and then reopened for other works almost immediately," Shaikh stated, underscoring the need for better planning.

Controversies and Allegations

The project has also been mired in controversy over alleged irregularities in upcoming tenders. BJP party executive member Vivekanand Gupta took to social media platform X to claim that a Rs 3,200 crore tender for roads in the western suburbs could unfairly favour a specific contractor, labelling it a "big scam." These allegations add to the scrutiny surrounding the BMC's execution and transparency.

Future Plans and Civic Response

Civic officials have clarified that while estimates for the new phase are still being finalised, no immediate works will commence. "We have been asked to work on preparing the estimates; however, none of these works will begin so soon as we are still in the process of identifying the roads that need to be concretised," a civic official explained. This cautious approach aims to address concerns over premature expansion and ensure thorough planning.

As Mumbai strives to become pothole-free, the BMC's road concretisation project represents a critical urban infrastructure upgrade. However, with political tensions rising and coordination issues persisting, the path forward requires careful management to achieve its goals without compounding existing challenges.
